Colas Rail Advances Abidjan Metro Electrical Works as Five Locomotives Arrive in Côte d’Ivoire

The start of feeder cable installation marks tangible progress on the traction power infrastructure required for Line 1 of the Abidjan Metro, moving the project further into systems installation ahead of future commissioning.

The arrival of five locomotives also strengthens Colas Rail Côte d’Ivoire’s operational resources in the country. Together, the developments point to continued investment in both project delivery and railway capability in Côte d’Ivoire.

Colas Rail Advances Abidjan Metro Electrical Works as Five Locomotives Arrive in Côte d’Ivoire
Photo credit: © Colas Rail Côte d’Ivoire
  • Colas Rail Côte d'Ivoire installed the first feeder cables on Abidjan metro Line 1 on 24 August 2026.
  • Approximately 1km of feeder cable was laid alongside Track 2 by the contractor's catenary teams, under the supervision of Samuel Brousse.
  • Feeder cables run in parallel with the overhead catenary and carry traction current from the electrical substations to trainsets operating on the line.
  • The next phase of feeder cable installation is scheduled for September 2026.
  • Five locomotives were received during August 2026, two on 2 August, two on 5 August and one on 12 August.
  • Africa Global Logistics was named as the service provider responsible for delivery and unloading, in an operation covering road survey, transport planning and heavy-lift handling.

Colas Rail Côte d’Ivoire advanced work on the traction power supply system for Line 1 of the Abidjan Metro during August 2026, while separately receiving five locomotives to strengthen its operational capabilities in the country.

On 24 August, the company’s catenary teams carried out the first installation of feeder cables along Track 2 of the Abidjan Metro.

Feeder cables form part of the railway’s electrical infrastructure and are installed in parallel with the overhead catenary system. They carry traction current from electrical substations to the catenary, which supplies power to trains operating on the line.

In a recent LinkedIn update, Colas Rail Côte d’Ivoire reported that the first operation covered 1km of feeder cable. The work was carried out under the supervision of Samuel Brousse, with a further phase of cable installation planned for September.

The work represents further progress in the installation of the electrical systems required ahead of the future commissioning of Line 1.

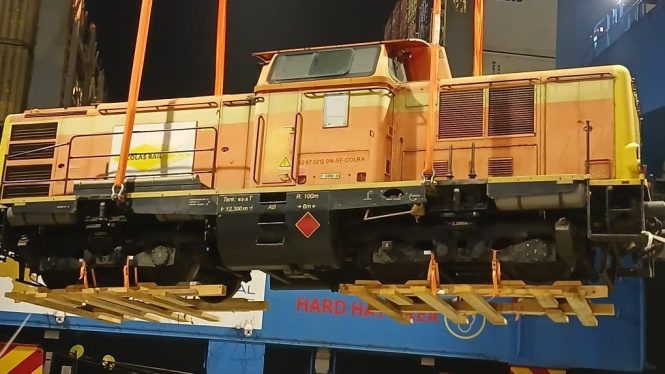

In a separate company update, Colas Rail Côte d’Ivoire reported that it had received five locomotives during August to strengthen its operational capabilities.

Two locomotives arrived on 2 August, followed by a further two on 5 August and the fifth on 12 August.

Their arrival involved road surveys, transport planning, heavy-lift handling and final unloading. The operation was coordinated by Colas Rail’s logistics and plant and equipment management teams in Abidjan, with support from its health, safety and environment function.

AGL was responsible for the delivery and unloading of the locomotives.
